It is more faster and easier to pass the PRINCE2-Exams PRINCE2-Practitioner exam by using Refined PRINCE2-Exams PRINCE2 Practitioner exam questuins and answers. Immediate access to the Leading PRINCE2-Practitioner Exam and find the same core area PRINCE2-Practitioner questions with professionally verified answers, then PASS your exam with a high score now.
Online PRINCE2-Practitioner free questions and answers of New Version:
NEW QUESTION 1
Project Scenario
Calendar Project (Note: The companies and people within the scenario are fictional.)
There has been a reduction in fie number of orders at the MNO Manufacturing Company due in part to the increased marketing activities of its competitors. To help counter this, the company has decided to create a promotional calendar for next year for all its current and prospective customers. The end product of this project will be a prepared calendar pack, ready for printing. The design of the calendar will be similar to one sent out previously, and must reflect the company image as described in the existing corporate branding standards. Another project is currently producing a new company logo when is to be printed on each page of the promotional calendar. The prepared calendar pack will consist of:
✑ Design for each month - correctly showing at public holidays and new company logo
✑ Selected photographs- 12 professionally-produced photographs, showing different
members of staff
✑ Selected paper and selected envelope - for printing and mailing the calendar
✑ Chosen label design - a competition to design a label will be held as part of this project
✑ List of customers - names and addresses of customers to whom the calendar will be sent.
The project is currently in initiation and will have two further stages:
Stage 2 will include tie activities to:
✑ Create the customer fast using information from the Accounts and Marketing departments
✑ Confirm compliance with the Data Protection Legislation
✑ Create a design for each month - this will be done by the internal creative team
✑ Select and appoint a professional photographer
✑ Gather photograph design ideas from previous project and agree photographic session schedule
✑ Prepare a production cost forecast
✑ Select paper and envelope.
Stage 3 will include the activities to:
✑ Produce and select tie professionally-taken photographs
✑ Hold the label design competition and choose the label design
✑ Assemble the prepared calendar pack.
A production cost forecast, based on the options and costs for the paper, envelope, printing and marketing of the calendar is to be produced in stage 2. However, the actual production and distribution of the calendars is not within the scope of the project. The product cost forecast will be reviewed by the Project Board to determine whether tie project should continue.
It is now 05 October and the prepared calendar pack must be delivered to the print
company by 30 November, to enable printing and distribution of the calendar in time for Christmas. The cost of the activities to develop the specialist products and the cost of the project management activities are estimated to be £20,000. There is a project time tolerance of +1 week /-2 weeks and a project cost tolerance of +£6,000 / -£6,000. A change budget of £500 has been allocated but there is no risk budget.
Whilst identifying the mailing costs for the calendars the Project Manager was surprised to find the costs could vary considerably depending on the size of the package and the delivery service used. For the purpose of this project, the Project Manager has selected an appropriate service but feels that a corporate standard for postage would have reduced the time and effort invested. It could reduce the company's overheads by up to £20k per year. How should the Project Manager record this observation within the project?
- A. Produce a project mandate, outlining the potential savings to be achieved by the introduction of a corporate standard.
- B. Make a note of the observation in the Daily Log to be transferred to a Benefits Review Plan at the end of the project.
- C. Record the observation in an Exception Report to the Project Board.
- D. Make an entry in the Lessons Log for future consideration by corporate management.
Answer: D
NEW QUESTION 2
Scenario
A photographer from Portraits Ltd, a professional photographic company, has taken on the role of Team Manager after taking some time to understand the requirements of the project. A contract for their services has been set up and is being monitored by the Purchasing Manager and a Work Package has been agreed. This contract specifies that the photographer must arrange a meeting with the Engineering Manager to establish a schedule for the photo sessions to minimize the impact on the Engineering staff. This meeting should have occurred by now.
The Engineering Manager was made aware of this requirement but when asked he reported that he has received no communication from the photographer. The Project Manager has tried to call the photographer and has had no response. The Project Manager believes there is a risk that Portraits Ltd are overbooking work and prioritizing other clients' work. If Portraits ltd do not deliver on schedule the project will be delayed and the expected benefits will be reduced.
The contract is to be reviewed and Portraits Ltd reminded of their agreement.
The project is now in stage 2. The Project Manager has heard about the possibility of a competitor also producing a calendar to be delivered earlier than the target date for this project. There is a threat that the early release of a competitor's calendar may weaken the impact of the MNO Manufacturing Company calendar, thereby reducing the anticipated benefits of the Calendar project.
Which 2 statements should be recorded under the Risk tolerance heading?
- A. Corporate management's threshold level of risk exposure is any combination of high and very high impact and probability.
- B. The Project Board's threshold level of risk exposure is any combination of medium, high and very high impact, with high and very high probability.
- C. The Project Manager's threshold level of risk exposure is low impact and probability.
- D. The cost of all fallback plans must be contained within the project's tolerance.
- E. The risk budget will have a tolerance of +/~ 10%.
Answer: BD
NEW QUESTION 3
While preparing the Quality Management Strategy, the Project Manager noticed that the corporate quality management system does not specifically cover project management.
Which option provides an appropriate way for the Project Manager proceed?
- A. Record the development of a corporate quality management system for project management as a prerequisite of the Project Plan.
- B. Proceed with the project without a Quality Management Strategy and adopt the selected service provider's standards in stage 4.
- C. Seek relevant organizational standards, then facilitate a workshop to discuss the Quality Management Strategy with Project Assurance.
Answer: C
NEW QUESTION 4
Which statement is an appropriate entry for the project approach heading within the Project Brief?
- A. The initial estimates from the feasibility study will be verified during the initiation stage.
- B. MFH must better manage suppliers' performance.
- C. The Information Technology Division and the Facilities Division will be outsourced to a single service provider.
- D. The Project Manager will be responsible for ensuring that the agreed project approach remains an appropriate choice.
Answer: C
NEW QUESTION 5
Additional Information
Chief Executive Officer (CEO): He started the company 25 years ago and knows his job very well. He injured his leg two years ago which has restricted his visits to the engineering area. As CEO he has an overall perspective of the business strategic requirements and the authority to commit resources as required.
Marketing Director: She has been with the company for three years, following a successful career with a publicity company. She has the ability to represent the needs of the business, particularly as this is a marketing project. She has the authority to commit the annual business marketing budget, from which the project will be funded, as she sees appropriate. She will be responsible for monitoring the expected benefits of the calendar, in particular the improvement of the company's image.
Engineering Manager: He has been responsible for many engineering innovations in the company and is still as keen and energetic as the day he started. VVhilst he will not be part of the project team, his staff will feature in the photos for the promotional calendar.
Central Records: This group of five staff looks after all company records and document control. They now maintain all project files.
Bright Lights: This is the local office supplies company. It supplies all the stationery and office equipment needs of the company and will supply the stationery for this project.
Portraits ltd: This is a professional photographic company with a number of excellent photographers and a history of successful work. This company has been selected to take the photos for the company calendar. It has yet be decided which of the photographers to use.
Which 2 statements explain why the Purchasing Manager should be appointed as a Senior Supplier for this project?
- A. He is responsible for the organization's procurement activates.
- B. He is responsible for the performance of supplier contracts.
- C. He was an engineer and worked in that area before taking up his current position.
- D. He can influence the external supplier's Business Case.
- E. He is not appropriate for the role of Executive or Senior User.
Answer: AB
NEW QUESTION 6
Additional Information
Further information on some resources who could be involved in the project: Outcome Account Manager: He represents Outcome which is a recruitment agency that
provides specialist outsourcing resources. Outcome provided the consultants who carried out the feasibility study and the same consultants will be providing support and guidance to the Information Technology and Facilities teams during the project.
Director of Finance Division: She was transferred from the Information Technology Division 12 months ago. She is responsible for ensuring a cost-conscious approach is adopted in all operational and project activities across the Ministry of Food Hygiene.
Hardware Manager: Reports to the Director of Information Technology. He provides computer hardware to all business functions but has little awareness of the needs of his colleagues working in software.
Payroll Manager: Reports to the Director of Finance. He is a very experienced and efficient qualified accountant who has much of the responsibility of running the Finance Division on behalf of the Director of Finance. He has been involved in drafting the Ministry's business strategy and assisting in a full business risk assessment. He also drafted the corporate Business Case standards.
Which 2 alternative actions apply to the proposed Executive for this project?
- A. Retain because he accepts that outsourcing is the best solution.
- B. Replace with 'Director of Finance Division' because she can ensure a cost-conscious approach to the project that gives value for money.
- C. Retain because he has the right level of authority to be able to control the strategic nature of the Outsourcing project.
- D. Add 'Director of Finance' because she understands the operation of the Information Technology Division and the Facilities Division.
- E. Replace with 'Payroll Manager' because he is a very experienced and efficient qualified accountant.
Answer: BC
NEW QUESTION 7
Who is responsible for ensuring that Communication Management Strategy is appropriate and that planned communication activities actually take place?
- A. Project Assurance
- B. Project Manager
- C. Corporate or Programme Management
- D. Project Support
Answer: A
NEW QUESTION 8

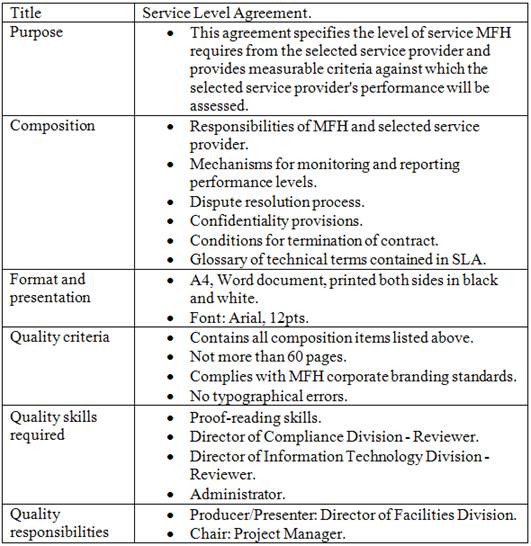

Additional Information Product Description
Quality notes from the Daily Log
The Director of Information Technology Division (DIT) has been asked to ensure that any changes to the outsourced staff employment contracts adhere to employment law. The DIT will review future job descriptions of the transferred staff before the final contract is signed with the selected service provider.
The service level agreement between MFH and the selected service provider will specify the type and quality of service required. The selected service provider must follow the industry standards for providing outsourced services.
MFH has a quality management system which contains a document control procedure for all its documentation, however this does not include change management.
All project documents will be subject to a quality review. Nominated products will require a formal approval record signed-off by the quality review chair.
Extract from the draft Quality Management Strategy (may contain errors) Introduction
1. This document defines the approach to be taken to achieve the required quality levels during the project.
2. The Project Board will have overall responsibility for the Quality Management Strategy.
3. Project Assurance will provide assurance on the implementation of the Quality Management Strategy.
Quality management procedure - Quality standards
4. The selected service provider will operate to industry standards for providing outsourced services.
5. MFH document standards will be used.
Records
6. A Quality Register will be maintained to record the planned quality events and the actual results from the quality activities.
7. Configuration Item Records will be maintained for each product to describe its status, version and variant.
8. Approval records for products that require them will be stored in the quality database. Roles and responsibilities
9. The DIT will check that the employment contracts for outsourced staff adhere to employment law.
10. Team Managers will provide details of quality checks that have been carried out.
11. Team Managers will ensure that the Quality Register is updated with the names of team members who are involved in the review process.
12. The Senior User will review the Product Descriptions of the products to be produced by the selected service provider to ensure that they can be achieved.
Which is a correctly defined acceptance criterion for the service level agreement (SLA) with the selected service provider?
- A. The SLA must extend for the full duration of the service contract.
- B. Any changes to the SLA must be managed through formal change control.
- C. External consultants are to assist in the creation of the SLA.
- D. The selected service provider should be located locally.
Answer: A
NEW QUESTION 9
Which role is responsible for providing the customer's quality expectations and acceptance criteria for the project?
- A. Executive
- B. Corporate or Programme Management
- C. Senior User
- D. Project Assurance
Answer: C
NEW QUESTION 10
HOTSPOT
Drop down the right answer from Column 1 to column 2.

- A. Mastered
- B. Not Mastered
Answer: A
Explanation:
NEW QUESTION 11
It is now late October and the project is in stage 3. The label design competition has been held and the photos of the staff have been taken. The CEO and Marketing Director still need to choose the winning label design and the 12 photos for the calendar. However, the Executive has learned that two competitors are issuing calendars to MNO's customers by the middle of November. After analyzing the impact of this Issue, one of the options the Project Manager has presented to the Project Board is to close the project prematurely.
There are a number of key facts relating to this project that would need to be recorded if the project Y-e to be closed now.
Which product should show that the photos could be used for other promotional material for the company?
- A. Benefits Review Plan
- B. Lessons Log
- C. Exception Report
- D. End Project Report
Answer: D
NEW QUESTION 12
Which of the following activities could trigger the production of an exception plan?
- A. Review Stage status
- B. Giving ad hoc direction
- C. Escalating a project issue
- D. Report stage end
Answer: B
NEW QUESTION 13
Project Scenario
Calendar Project (Note: The companies and people within the scenario are fictional.)
There has been a reduction in fie number of orders at the MNO Manufacturing Company due in part to the increased marketing activities of its competitors. To help counter this, the company has decided to create a promotional calendar for next year for all its current and prospective customers. The end product of this project will be a prepared calendar pack, ready for printing. The design of the calendar will be similar to one sent out previously, and must reflect the company image as described in the existing corporate branding standards. Another project is currently producing a new company logo when is to be printed on each page of the promotional calendar. The prepared calendar pack will consist of:
✑ Design for each month - correctly showing at public holidays and new company logo
✑ Selected photographs- 12 professionally-produced photographs, showing different
members of staff
✑ Selected paper and selected envelope - for printing and mailing the calendar
✑ Chosen label design - a competition to design a label will be held as part of this project
✑ List of customers - names and addresses of customers to whom the calendar will be sent.
The project is currently in initiation and will have two further stages:
Stage 2 will include tie activities to:
✑ Create the customer fast using information from the Accounts and Marketing departments
✑ Confirm compliance with the Data Protection Legislation
✑ Create a design for each month - this will be done by the internal creative team
✑ Select and appoint a professional photographer
✑ Gather photograph design ideas from previous project and agree photographic session schedule
✑ Prepare a production cost forecast
✑ Select paper and envelope.
Stage 3 will include the activities to:
✑ Produce and select tie professionally-taken photographs
✑ Hold the label design competition and choose the label design
✑ Assemble the prepared calendar pack.
A production cost forecast, based on the options and costs for the paper, envelope, printing and marketing of the calendar is to be produced in stage 2. However, the actual production and distribution of the calendars is not within the scope of the project. The product cost forecast will be reviewed by the Project Board to determine whether tie project should continue.
It is now 05 October and the prepared calendar pack must be delivered to the print company by 30 November, to enable printing and distribution of the calendar in time for Christmas. The cost of the activities to develop the specialist products and the cost of the project management activities are estimated to be £20,000. There is a project time tolerance of +1 week /-2 weeks and a project cost tolerance of +£6,000 / -£6,000. A change budget of £500 has been allocated but there is no risk budget.
At the end of initiation there is +1 week 1-2 weeks time tolerance for this project. Which statement is true?
- A. There can be no time tolerances for any of the stages.
- B. All of the project level time tolerance can be allocated to stage 2.
- C. The Stage Plan for stage 2 could create some additional project time tolerance by allowing no time tolerance in Team Plans.
- D. Additional time tolerance for the project could be found by adding extra resources without affecting other tolerances.
Answer: B
NEW QUESTION 14
Scenario
A photographer from Portraits Ltd, a professional photographic company, has taken on the role of Team Manager after taking some time to understand the requirements of the project. A contract for their services has been set up and is being monitored by the Purchasing Manager and a Work Package has been agreed. This contract specifies that the photographer must arrange a meeting with the Engineering Manager to establish a schedule for the photo sessions to minimize the impact on the Engineering staff. This meeting should have occurred by now.
The Engineering Manager was made aware of this requirement but when asked he reported that he has received no communication from the photographer. The Project Manager has tried to call the photographer and has had no response. The Project Manager believes there is a risk that Portraits Ltd are overbooking work and prioritizing other clients' work. If Portraits ltd do not deliver on schedule the project will be delayed and the expected benefits will be reduced.
The contract is to be reviewed and Portraits Ltd reminded of their agreement.
The project is now in stage 2. The Project Manager has heard about the possibility of a competitor also producing a calendar to be delivered earlier than the target date for this project. There is a threat that the early release of a competitor's calendar may weaken the impact of the MNO Manufacturing Company calendar, thereby reducing the anticipated benefits of the Calendar project.
Which 2 statements should be recorded under the Proximity heading?
- A. Proximity categories for this project are: Imminent; Within the stage; Within the project; Beyond the project.
- B. The risk of MFH having no outsourcing experience will be categorized as Stage 4proximity.
- C. Imminent risks are those which may occur within two weeks.
- D. Any risk with a proximity category of imminent will be estimated as having a very high impact.
- E. The risk of staff leaving the organization will be categorized as beyond the project proximity.
Answer: CD
NEW QUESTION 15
Additional Information Product Description
Quality notes from the Daily Log
The Director of Information Technology Division (DIT) has been asked to ensure that any changes to the outsourced staff employment contracts adhere to employment law. The DIT will review future job descriptions of the transferred staff before the final contract is signed with the selected service provider.
The service level agreement between MFH and the selected service provider will specify the type and quality of service required. The selected service provider must follow the industry standards for providing outsourced services.
MFH has a quality management system which contains a document control procedure for all its documentation, however this does not include change management.
All project documents will be subject to a quality review. Nominated products will require a formal approval record signed-off by the quality review chair.
Extract from the draft Quality Management Strategy (may contain errors) Introduction
1. This document defines the approach to be taken to achieve the required quality levels during the project.
2. The Project Board will have overall responsibility for the Quality Management Strategy.
3. Project Assurance will provide assurance on the implementation of the Quality Management Strategy.
Quality management procedure - Quality standards
4. The selected service provider will operate to industry standards for providing outsourced services.
5. MFH document standards will be used.
Records
6. A Quality Register will be maintained to record the planned quality events and the actual results from the quality activities.
7. Configuration Item Records will be maintained for each product to describe its status, version and variant.
8. Approval records for products that require them will be stored in the quality database. Roles and responsibilities
9. The DIT will check that the employment contracts for outsourced staff adhere to employment law.
10. Team Managers will provide details of quality checks that have been carried out.
11. Team Managers will ensure that the Quality Register is updated with the names of team members who are involved in the review process.
12. The Senior User will review the Product Descriptions of the products to be produced by the selected service provider to ensure that they can be achieved.
Which statement applies to the Introduction section?
- A. Delete entry 1 because the project approach is defined in the Project Brief.
- B. Delete entry 2 because this is the Project Manager's responsibility.
- C. Delete entry 3 because it is the Project Manager's responsibility to implement the Quality Management Strategy.
- D. Move entry 3 to the Roles and responsibilities section because this is a quality responsibility.
Answer: D
